Daikin EMRQ16ABY1 [20/36] Installation of refrigerant piping leak test vacuuming after electrical installation is done on any indoor or outdoor unit

Daikin EMRQ16ABY1 [20/36] Installation of refrigerant piping leak test vacuuming after electrical installation is done on any indoor or outdoor unit
Installation manual
17
EMRQ8~16ABY1
Daikin Altherma outdoor unit
4P501819-1 2017.08
Installation of refrigerant piping, leak test, vacuuming before
electrical installation is done (regular installation method)
When all piping work is complete, it is necessary to:
check for any leakages in the refrigerant piping and
to perform vacuum drying to remove all moisture in the
refrigerant piping.
If there is a possibility of moisture being present in the refrigerant
piping (for example, rainwater may have entered the piping), carry out
the vacuum drying procedure below until all moisture has been
removed and consider the installation of a liquid dryer.
All piping inside the unit has been factory tested for leaks.
Only eld installed refrigerant piping needs to be checked. Therefore,
make sure that all the outdoor unit stop valves are rmly closed
before performing leak test or vacuum drying.
See "Set-up" on page 17, "Leak test" on page 18, and "Vacuum
drying" on page 18.
Installation of refrigerant piping, leak test, vacuuming after
electrical installation is done on any indoor or outdoor unit
Apply outdoor unit setting 2-21=1 (see page 29) before starting leak
test and vacuuming. This setting will open all eld expansion valves
and solenoid valves to guarantee a R410A piping pathway.
When all piping work is complete, it is necessary to:
check for any leakages in the refrigerant piping and
to perform vacuum drying to remove all moisture in the
refrigerant piping.
If there is a possibility of moisture being present in the refrigerant
piping (for example, rainwater may have entered the piping), rst
carry out the vacuum drying procedure below until all moisture has
been removed and consider the installation of a liquid dryer.
All piping inside the unit has been factory tested for leaks.
Only eld installed refrigerant piping needs to be checked. Therefore,
make sure that all the stop valves are rmly closed before performing
leak test or vacuum drying.
See "Set-up" on page 17, "Leak test" on page 18, and "Vacuum
drying" on page 18.
Set-up
NOTE
Make sure that ALL indoor unit stop valves are OPEN
(no outdoor unit stop valves!) before you start leak test
and vacuuming.
NOTE
Make sure that ALL indoor unit stop valves are
OPEN (no outdoor unit stop valves!) before you
start leak test and vacuuming.
Make sure that ALL indoor units connected to the
outdoor unit are powered on.
Wait untill the outdoor unit has nished the
initialisation.

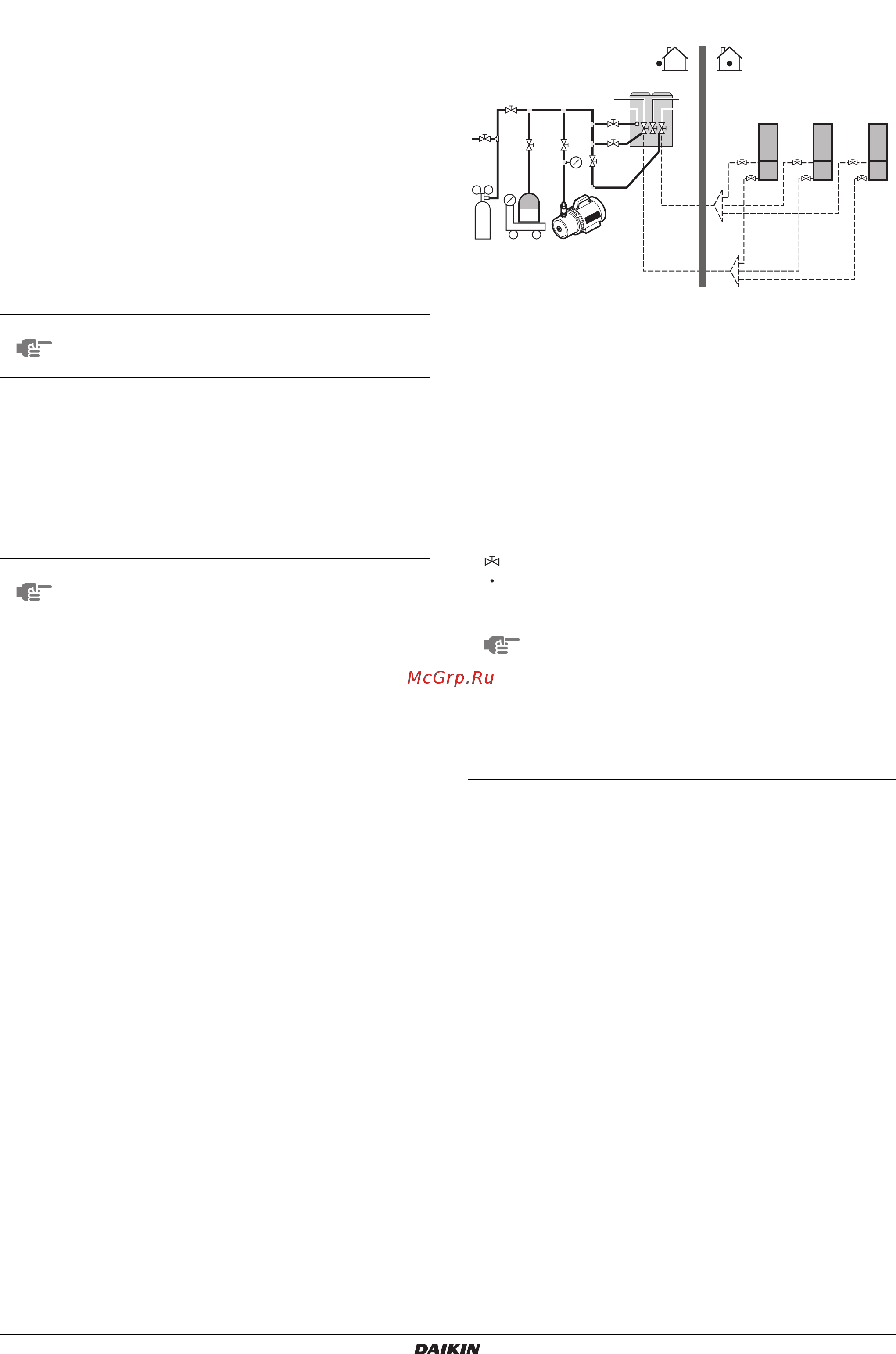

1 Pressure reducing valve
2 Nitrogen
3 Refrigerant R410A tank (siphon system)
4 Measuring instrument
5 Vacuum pump
6 Suction pipe stop valve (not used)
7 Outdoor unit
8 Liquid pipe stop valve
9 Indoor unit(s)
10 Charge hose
11 Refrigerant charge port
12 Discharge pipe stop valve
Valve
Stop valve service port
NOTE
The connections to the indoor units and all indoor units
should also be leak and vacuum tested. Keep the stop
valves of the indoor units open as well.
Refer to the indoor unit installation manual for more
details.
Leak test and vacuum drying should be done before
the power supply is set to the unit. See also the ow
chart earlier described in this chapter.
VACU
8
6
1
2
3
45
8
11
12
7
9 9 9
12
4PEN501819-1.book Page 17 Wednesday, September 13, 2017 12:52 PM
